First Article Inspection (FAI): What B2B Buyers Must Verify on the First Production Unit
Most buyers assume that if the sample passed, mass production will be fine. This is the wrong assumption.
The approved sample is typically built in a workshop by senior technicians. The first production unit comes off the actual assembly line, with regular workers, standard tooling, and bulk materials. The gap between these two is where most quality problems start.
First Article Inspection (FAI) is the checkpoint that closes this gap. Done correctly, it catches roughly 30% of manufacturing issues before they are replicated across hundreds or thousands of units.
- FAI is not another sample approval — it verifies that the production line itself can replicate the approved quality
- The most common failures are dimensional deviations and component substitutions, not cosmetic issues
- Skipping FAI saves a few days of lead time but typically costs 8–12x more in rework, returns, or customs problems later
- For first orders or significant design changes, FAI is always worth the time and cost
Key Facts
- Approximately 30% of first-run production issues are identified during FAI, with dimensional accuracy and material substitution being the two most common failure categories (ASQ First Article Inspection Benchmark Report, 2025).
- Orders that skip formal FAI show an average 8–12x higher cost of rework and post-shipment quality issues compared to orders with documented first article approval (Quality Digest Manufacturing Cost Study, 2026).
- For customized kitchen appliances, 65% of FAI processes require at least one revision before full approval, especially when custom tooling or modified internal components are involved.
- Dimensional deviations account for roughly 28% of FAI failures, followed by material or component substitutions at 22%, and functional performance issues at 18% (HQTS Small Appliance Inspection Data, 2025).
- Companies with standardized FAI documentation report 65% fewer recurring production defects across repeat orders, because the first article serves as a physical baseline for every subsequent batch.
What Is First Article Inspection (FAI)?
First Article Inspection is the formal verification of the very first unit (or first few units) that comes off the actual mass production line.
It is not a quality check on another hand-built sample. It is a validation that the production process itself — the tooling, the materials, the workers, the assembly sequence — is capable of producing units that match your approved specifications.
FAI matters because workshop samples and production line samples are built differently. A skilled technician working slowly on one unit can achieve tolerances and finishes that a line worker assembling 50 units per shift cannot. FAI confirms what the real production output will look like.
For kitchen appliances specifically, FAI catches problems that sample testing alone misses: slight housing dimension shifts that affect assembly alignment, bulk material batches that differ from the sample grade, and calibration drift on production line test equipment.
First-time importers often overlook FAI in their production planning, assuming sample approval is sufficient. This is one of the most common causes of quality discrepancies between sample and bulk orders.
For buyers comparing multiple factories before placing an order, our air fryer factory audit checklist includes a full section on how to evaluate a supplier's FAI and production quality verification processes.

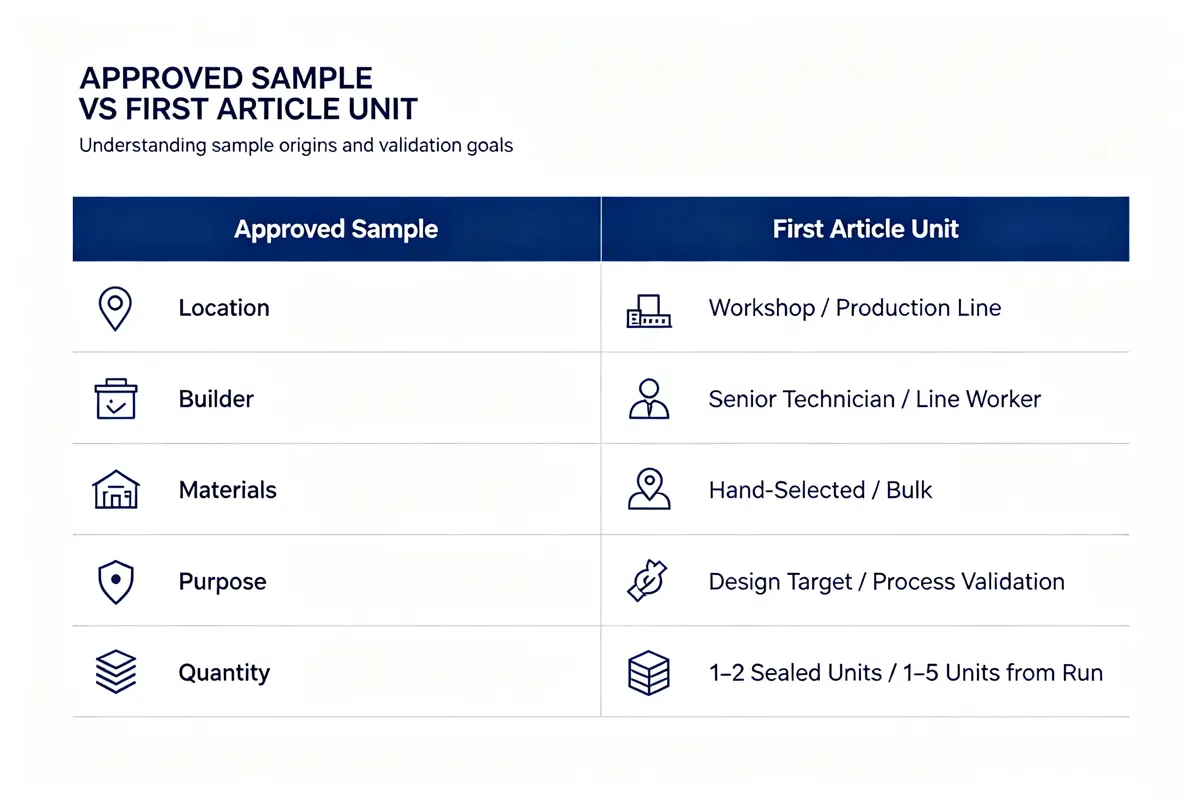

FAI vs. Approved Sample: What's the Difference?
Buyers often confuse these two. They serve different purposes and both are necessary.
Figure 1: Key differences between an approved golden sample and a first article production unit
| Aspect | Approved Sample (Golden Sample) | First Article Unit |
|---|---|---|
| Built where | Workshop / sample department | Actual production line |
| Built by | Senior technicians | Regular production line workers |
| Materials used | May use premium or hand-selected parts | Bulk production materials from regular inventory |
| Purpose | Confirms the design and specification target | Confirms the production process can hit that target |
| Quantity | 1–2 units, sealed and stored | 1–5 units from the beginning of the first production run |
| Approval basis | Visual and functional review against spec sheet | Full dimensional, material, functional and safety verification |
Think of it this way: the golden sample is the answer key. FAI checks whether the production machine is grading correctly.
The 7 Categories of FAI Verification

A proper FAI covers more than just "does it turn on." Here is what must be verified on the first production unit.
Figure 2: Seven verification categories in a complete kitchen appliance FAI process
1. Dimensional Accuracy
Every critical dimension is measured and compared against the engineering drawing. For kitchen appliances, this includes housing fit, basket clearance, lid seal compression, control panel alignment, and foot flatness.
Even a 0.5mm deviation that is invisible to the eye can cause rattling, poor sealing, or assembly problems downstream. Dimensional issues are the single most common FAI failure category.
2. Material and Component Verification
Components are checked against the BOM (Bill of Materials) to confirm that the production line is using the specified grades, brands, and part numbers.
This is where material substitutions are caught — the factory switching to a cheaper plastic grade, a different heating element supplier, or a non-approved coating. The sample may have used the premium version; FAI confirms the bulk version matches.
3. Functional Performance
The unit runs through full operational cycles at maximum settings. For an air fryer, this means full temperature and timer verification, preheat time measurement, and fan performance assessment. For an electric pressure cooker, it means pressure build-up rate, seal integrity, and pressure release function.
4. Electrical Safety Testing
Full electrical safety tests are performed — grounding continuity, insulation resistance, leakage current, and dielectric strength — using the same test equipment and procedures that will be used on every production unit.
This verifies not just that the unit is safe, but that the production line's safety testing equipment is calibrated and the line workers are performing the tests correctly. Cross-reference with our CE certification guide for kitchen appliances to confirm which safety standards apply to your product category.
5. Cosmetic and Finish Quality
All visible surfaces are inspected under standard lighting conditions: housing color, coating uniformity, print quality, button feel, door gap consistency, and surface defects.
6. Labeling and Marking
Every label, rating plate, and marking is verified: voltage and power ratings, model number, certification marks, country of origin, warning labels, and instruction manual language.
Labeling errors are surprisingly common and can cause customs detention or compliance issues even if the product itself is correct. If you are sourcing ErP-covered products, this is also the stage to verify standby power consumption labeling against ErP 2026 requirements.
7. Packaging and Accessories
The unit is packed in the actual production packaging with all accessories. Drop test or transit simulation may be performed at this stage if required.
We require dual sign-off on every first article — both the production manager and the QC department manager must confirm and sign the FAI report before mass production proceeds. This creates internal accountability that a single-signature approval does not.
Explore APEXDURA's standardized production process — documented first article reports are available for buyer review on every production run.
The FAI Process Step by Step
- Production line setup: The factory sets up the full production line with all tooling, materials, and fixtures for your order.
- First unit produced: The first complete unit comes off the end of the line, using the standard production sequence.
- QC team takes possession: The quality control team takes the unit to the inspection area, separate from the production floor.
- Full verification performed: All 7 categories above are inspected, measured, and tested against the approved specification and golden sample.
- FAI report documented: Every measurement and test result is recorded in a formal first article inspection report with photos.
- Buyer review (if required): For first orders or custom products, the report and photos are sent to the buyer for review and written approval.
- Production hold or release: If FAI passes, full production proceeds. If it fails, corrections are made and a new first article is produced for re-inspection.
Honest Recommendation: When You Don't Need a Full FAI
- Repeat order of unchanged product
- No component/tooling changes
- Small order quantity / low risk
- Proven process stability
- First order with this factory
- Any design or material changes
- New production line/location
- Large, financially significant order
Common FAI Failures and Root Causes
Dimensional Shift from Tooling Wear
The production tooling or fixtures are slightly worn or misaligned compared to what was used for the sample. The part still fits, but not to the specified tolerance.
Fix: Tooling adjustment or replacement, then re-FAI.
Bulk Material Grade Difference
The bulk production material batch has slightly different properties than the sample material — different plastic shrinkage rate, different coating thickness, or a different supplier's equivalent part.
Fix: Either approve the difference if it is within tolerance, or require the factory to source the correct material grade.
What Happens If FAI Fails?
A failed FAI is not a disaster — it is the entire point of the process. Catching the problem at one unit is always better than catching it at 500 units.
- The factory identifies the root cause and proposes a corrective action
- You review and approve the correction plan
- The factory implements the fix and produces a new first article
- FAI is repeated on the new unit
- Only after passing FAI does full production begin
FAI Checklist
Figure 3: Printable FAI checklist for kitchen appliance production verification
FAQ
No. A pre-production sample is built in the sample department before the production line is set up. FAI uses the first unit off the actual production line with standard materials, workers, and tooling.
Typically 1–3 days for the inspection and report. If FAI fails and corrections are needed, add 3–10 days depending on the fix required.
For standard products, 1 unit is usually sufficient. For high-volume or safety-critical products, 3–5 consecutive units confirms process stability.
Ready to discuss FAI and quality standards?
Send us your product specifications, target market and quantity — we'll outline our first article inspection process and quality documentation standards.
Source Kitchen Appliances with APEXDURA
APEXDURA manufactures small kitchen appliances for European brands and importers, with standardized quality control processes at every production stage.
- ✅ Formal FAI on every first production run with dual-department sign-off
- ✅ Full documented inspection reports with measurement data and photos
- ✅ Independent QC team separate from production management
- ✅ First article samples retained for reference
📧 Email: devin@zszhenmei.com
📱 WhatsApp: +86 136 1272 5240
🔗 Request a Quality Process Overview
