Production Slot Booking for Q4 Kitchen Appliance Orders

2026-08-03

Q4 appliance orders are not won only by negotiating a unit price. They are won by locking the right production window before material, labour, inspection and freight capacity tighten. This guide shows kitchen appliance importers how to secure Chinese factory production slots before the 2026 Mid-Autumn Festival, National Day Golden Week and year-end retail shipping pressure.

A purchase order does not automatically reserve a production line. In peak season, a factory still has to balance confirmed orders, material availability, mould or tooling capacity, assembly-line allocation, packaging readiness, inspection timing and cargo handover. If the buyer has not approved samples, frozen key components or confirmed packaging artwork, the “slot” may be more of an intention than a reliable schedule.

For 2026, the calendar deserves extra attention. China’s Mid-Autumn Festival holiday is September 25-27, and the National Day holiday runs October 1-7. That leaves only a narrow working window between the two breaks, while freight markets are already in their usual second-half peak-season period. Buyers who need Q4 retail stock should treat August as the month to make decisions, not the month to start vague conversations.

Key Takeaways

  • A production slot should include more than a line date: it should connect sample approval, BOM freeze, material order, packaging artwork, inspection and cargo-ready date.
  • For 2026, the Mid-Autumn holiday on September 25-27 and National Day holiday on October 1-7 compress the usable pre-holiday production and logistics window.
  • Buyers should lock Q4 appliance decisions in August whenever possible, especially for customized panels, colours, packaging, accessories, smart features or market-specific documents.
  • A factory can reserve capacity more confidently when the buyer provides target market, confirmed quantity, approved sample status, compliance requirements and a realistic shipment window.
  • The highest-risk projects are those that ask for a fixed delivery date while sample approval, packaging, certification scope or payment terms are still unsettled.

What “Booking a Production Slot” Really Means

In a kitchen appliance project, booking a production slot is not the same as asking the factory to “make it in September.” A useful slot has a start window, an output target, required materials, a production line or work-centre plan, quality checkpoints and a cargo-ready date. It also has release conditions: what must be approved before the factory can safely allocate materials and line time.

Capacity planning in manufacturing is built around demand, available labour, equipment, shifts, work centres and material constraints. A factory may have enough total monthly capacity but still lack the right line, tooling, component supply or trained operators for one specific appliance model in a specific week.

This is why buyers should move the conversation from “Can you deliver before Q4?” to “What must be locked before you can reserve a realistic production window?” The second question creates a practical schedule.

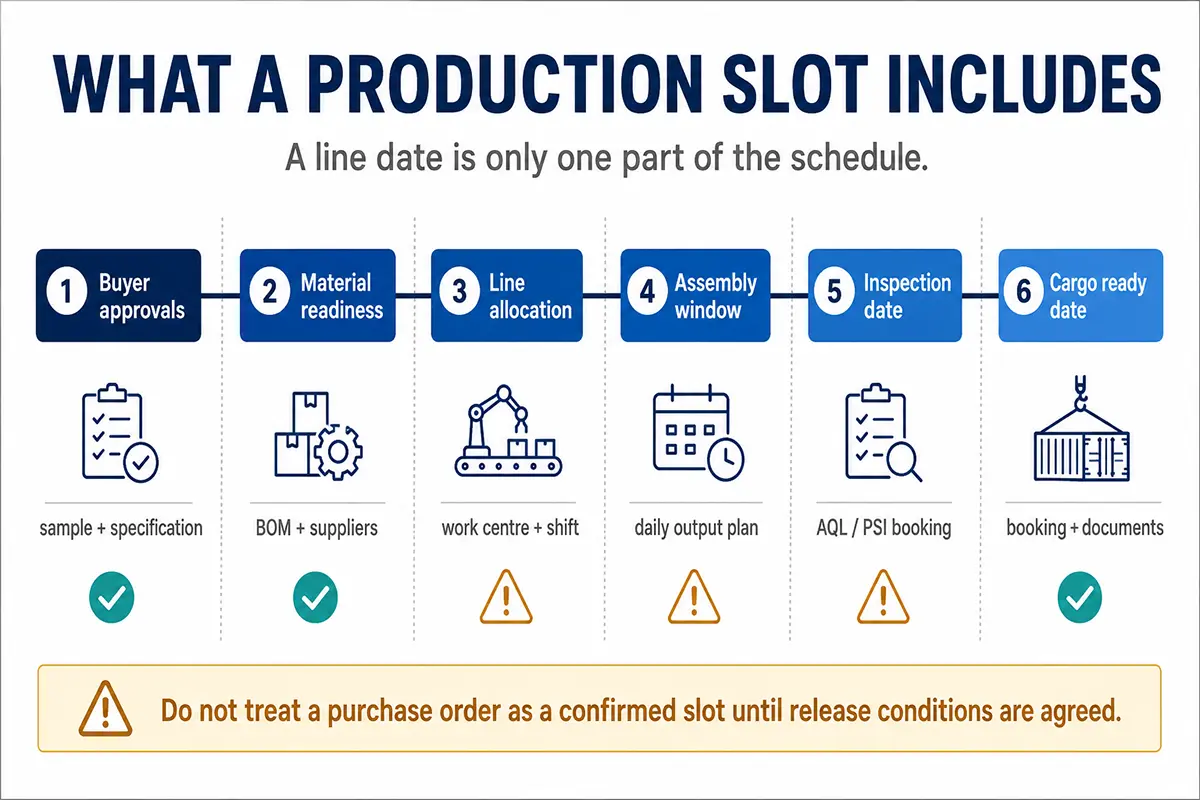

Kitchen appliance production slot definition connecting approvals, capacity, inspection and cargo ready date

The 2026 Calendar Risk: Mid-Autumn, Golden Week and Freight Peak

The official 2026 Chinese public holiday schedule lists Mid-Autumn Festival from September 25 to 27 and National Day from October 1 to 7. September 20 and October 10 are adjusted working days, but buyers should not assume those make up for every factory, supplier and logistics bottleneck created by the holiday pattern.

Golden Week affects more than the seven holiday dates. Logistics providers commonly warn that factories close or reduce operations, ocean carriers may omit sailings, and a pre-holiday rush often starts two or three weeks before the break as exporters try to move cargo before the shutdown. Flexport also describes the main retail peak season as the August-to-October period leading up to Golden Week, Black Friday, Cyber Monday and Christmas inventory needs.

For appliance buyers, the practical consequence is simple: a late September inspection is not a comfortable backup plan. If the goods fail inspection, if cartons need correction, if a component is short or if the booking is rolled, the recovery window before October 1 is extremely tight.

Planning checkpoint Why it matters in 2026 Buyer action
Early August Enough time remains to finalize sample, order materials and reserve capacity before the pre-holiday rush. Confirm model, target market, order quantity, customization and evidence needs.
Mid-August Material, packaging and freight planning should become concrete for Q4 stock. Freeze BOM, approve artwork route, review payment and request preliminary cargo-ready date.
Late August Factories begin prioritizing orders that are complete enough to schedule. Confirm production slot, inspection plan and shipment method assumptions.
Early September Pre-Golden Week freight pressure can start building before the official holiday. Book inspection resources and align forwarder booking around realistic CRD.
Mid-September Rework options narrow if final inspection finds major problems. Avoid first-time discoveries; use inline checks or early production confirmation.
Late September Mid-Autumn holiday and National Day preparation compress remaining working days. Use only for controlled handover, not unresolved product decisions.

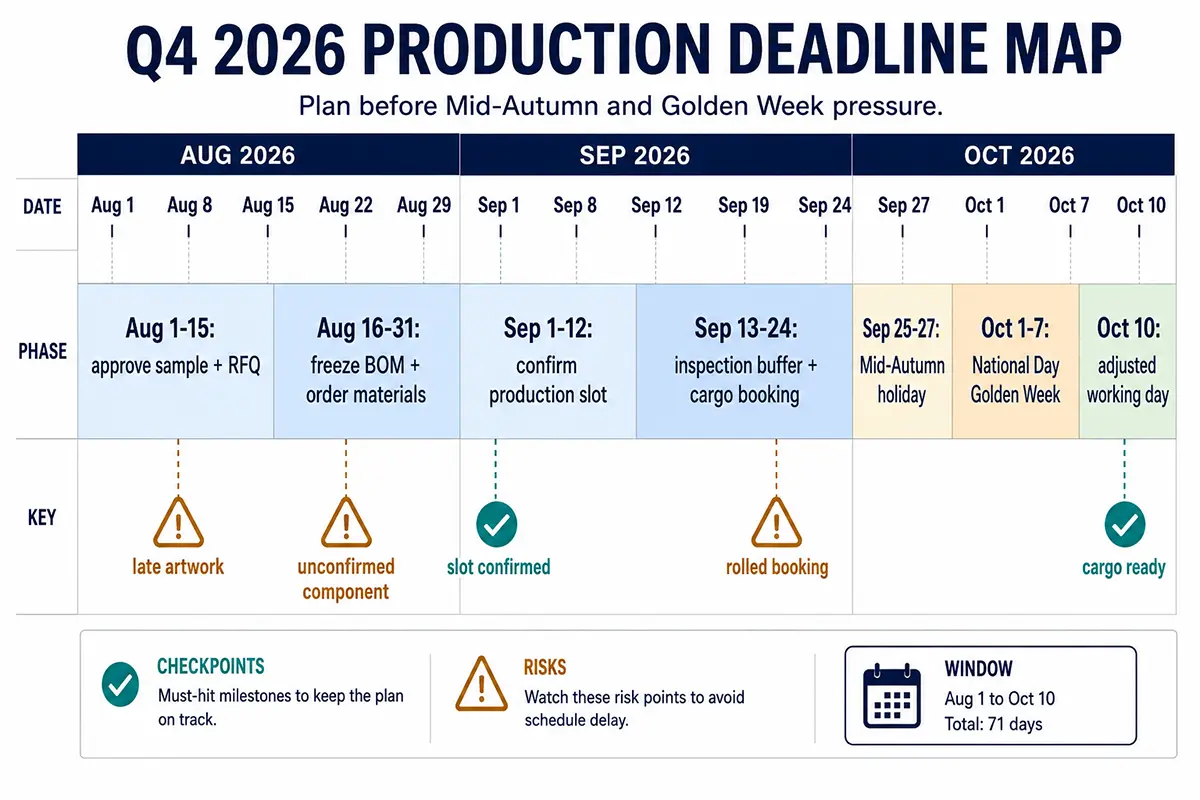

China Q4 2026 production deadline calendar for kitchen appliance orders before Golden Week

Five Conditions to Lock Before Asking for a Line Date

A factory can plan more reliably when the buyer removes ambiguity. Before requesting a firm production slot, prepare five conditions.

1. Approved Product Direction

The product direction should define the category, capacity or key specification range, market positioning and must-have features. For example, a buyer sourcing air fryers should not only ask for “5L digital model.” The brief should clarify whether the product targets entry-level promotion, mid-range family use, dual-basket differentiation, smart features or air fryer oven positioning.

For category planning, buyers can review APEXDURA’s air fryer, electric pressure cooker, coffee machine, juicer and blender product ranges before finalizing the RFQ.

2. Sample Approval Route

Sample approval should specify what the sample must prove: appearance, function, cooking performance, control panel, accessory fit, packaging structure, language layout, safety documentation or food-contact material evidence. A sample without a clear approval route often leads to repeated revisions.

APEXDURA’s OEM/ODM page includes sample production and testing as part of the project process, but timelines must still be confirmed by model, customization scope and order quantity. Buyers should not treat any sample-stage reference as a fixed delivery promise for every project.

3. Frozen BOM and Change Rules

The BOM is the bridge between the approved sample and mass production. If a motor, heating element, PCB, coating supplier, seal material or packaging structure can change without buyer approval, the production slot may still carry quality and compliance risk.

The stronger approach is to define which components are locked, which alternatives are pre-approved and what triggers a re-sample, additional test or buyer sign-off. This also supports cost-of-quality control because late substitutions can create hidden inspection, rework and after-sales costs.

4. Packaging and Documentation Readiness

Many Q4 delays are not caused by the appliance itself. They come from late artwork, missing language versions, barcode changes, carton dimensions, pallet loading assumptions, user manual revisions or unclear certification marks. Packaging should be treated as part of the production release gate, not an afterthought.

For EU and UK shipments, documentation also connects to CE, RoHS, REACH, WEEE, food-contact materials and market-specific instructions where applicable. Buyers can use APEXDURA’s CE certification guide and certificate information page as starting points, while confirming exact model scope during RFQ.

5. Payment, Deposit and Commercial Release

Factories rarely allocate peak capacity based only on casual interest. A slot becomes more credible when the commercial route is clear: agreed quantity, price basis, deposit schedule, tooling cost if any, packaging cost, inspection responsibility and shipment term.

If payment terms or MOQ remain unresolved, the buyer may receive a tentative date that later moves behind confirmed orders. Review APEXDURA’s MOQ and payment terms guidance before negotiating peak-season capacity.

A Practical Q4 Slot Booking Checklist

Use the following checklist before asking a supplier to commit to a Q4 production date. It is deliberately strict because peak-season uncertainty punishes vague projects.

Release item Buyer should provide Factory should confirm Do not release if...
Product specification Model direction, capacity, control type, feature list and target market. Available platform, customization feasibility and sample path. The product brief still changes every meeting.
Approved sample Approval criteria and comments on appearance, function, accessories and packaging. Whether the approved sample matches production materials and process. The booth or sales sample differs from the planned production build.
BOM and materials Locked critical components and rules for substitutions. Material lead times, supplier status and alternative-component approval method. Key parts have no confirmed source or version record.
Compliance file Target market and required document types. Model-specific certificate, report or declaration status where applicable. Documents are only generic family files with unclear scope.
Packaging Artwork route, manual language, carton requirements and barcode rules. Artwork deadline, print proof timing and packaging material lead time. Retail packaging is still being redesigned.
Inspection plan AQL level, inspection timing, responsible party and release rules. Factory QC checkpoints and final inspection date options. There is no buffer for rework or reinspection.
Logistics Destination, shipment method, forwarder and required cargo-ready date. Loading plan, document timing and handover window. The shipment plan depends on one late September fallback booking.

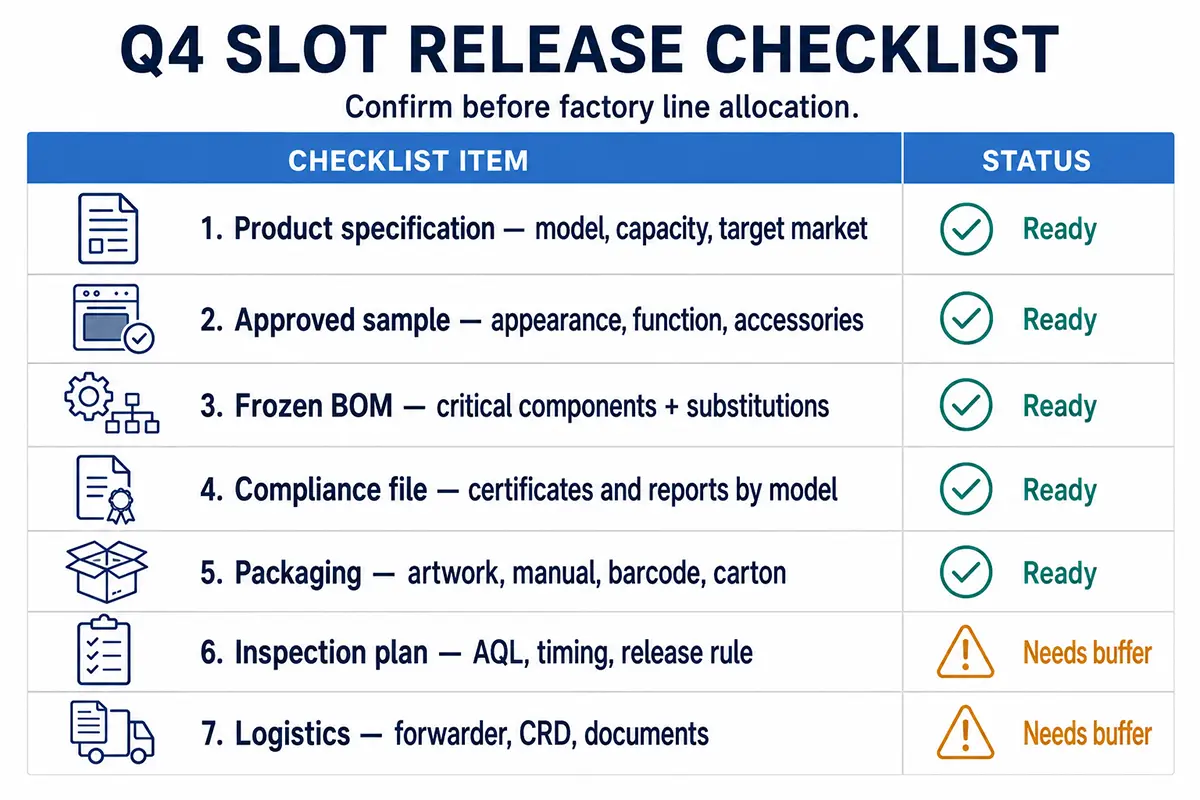

Q4 appliance production release checklist for specification, sample, BOM, compliance and logistics

How to Negotiate a Slot Without Overpromising

Buyers sometimes push for a fixed ship date before the project has enough information to support one. That creates tension later. A better negotiation separates firm commitments from assumptions.

Negotiation point Weak wording Better wording
Production window Can you finish before October? If we approve sample and freeze BOM by August 15, what production window can you reserve?
Material readiness Do you have materials? Which critical materials require purchase now, and which supplier lead times affect the slot?
Inspection timing Inspection can happen after production. Which date can support final inspection and still leave time for rework before cargo handover?
Customization We may change colour later. What is the last date to confirm colour, panel, plug, manual and gift box without moving the slot?
Payment We will confirm soon. What commercial release condition is required before capacity and materials are reserved?

This approach also protects the buyer. If the supplier later misses a date, both sides can check whether the release conditions were met. If they were not met, the problem is not simply “factory delay”; it may be an approval, material or documentation delay.

Inspection and Logistics Buffers Are Part of the Slot

A production slot that ends the day before a vessel closing date is not a safe plan. Kitchen appliance orders require inspection, possible rework, carton marking checks, export documents, truck booking and container loading. If the buyer uses a third-party inspection provider, the inspection date must be booked early enough for travel, sampling and report review.

Peak-season freight also changes the risk calculation. Flexport’s peak-season guidance notes that ocean FCL shipments are commonly booked weeks before cargo-ready date, and that LCL can take longer than FCL. DHL’s Golden Week guidance also describes pre-holiday volume surges, factory closures and carrier sailing omissions around the holiday period. Exact lanes and years vary, so buyers should confirm with their own forwarder, but the planning principle is stable: do not leave freight decisions until the factory finishes production.

For logistics preparation, buyers can review APEXDURA’s China-Europe kitchen appliance logistics guide and align the production slot with forwarder booking, palletisation, carton dimensions and customs documents.

Red Flags That the Slot Is Not Really Locked

  • The supplier gives a production month but no cargo-ready date, inspection window or release conditions.
  • The buyer has not approved the sample, but the supplier claims the line is already fixed.
  • Critical components are not identified, or alternative suppliers can be used without buyer approval.
  • Packaging artwork, manual languages, plug type or barcode information remain open.
  • The quote excludes certification, testing, packaging or customization items that affect timing.
  • The inspection date is after the last realistic rework window.
  • The freight plan assumes space will be available during the pre-Golden Week rush without an early booking.

Honest Advice: Sometimes You Should Not Lock the Slot Yet

If the product direction is still changing, the target market is unclear or the buyer has not decided whether the product is entry-level, mid-range or premium, forcing a production slot can create waste. In that situation, it is better to lock a sample-development plan first, then reserve production only after the commercial brief and key evidence are stable.

Example Scenario: The Late August Decision

A European importer wants to launch a private-label air fryer oven for November promotions. By August 20, the buyer has chosen the product platform and target price, but the gift box design is unfinished and the coating evidence has not been reviewed. The supplier says production may be possible in mid-September if materials are ordered immediately.

A weak decision would be to approve the order based only on the verbal production window. A stronger decision is to split the project into release gates: approve functional sample, freeze the key BOM, confirm coating and food-contact evidence, finalize packaging by a fixed date, book inspection before the Mid-Autumn holiday and ask the forwarder for booking options against the planned cargo-ready date.

If the packaging or evidence file slips, the buyer can see which gate moved the schedule. That clarity helps the buyer decide whether to accept a later sailing, reduce customization, split shipment, or shift the launch window.

How APEXDURA Can Support Slot Planning

APEXDURA is the international brand of Zhongshan Zhenmei Electrical Appliance Co., Ltd., with over 16 years of OEM/ODM kitchen appliance manufacturing experience. Public website information describes one-stop OEM/ODM support from project communication, customization, sampling, production, inspection, packaging and shipment coordination. For Q4 projects, the useful conversation is not “how fast can you ship?” but “which project details must be confirmed to make the schedule realistic?”

Buyers can use the OEM/ODM service page, production process overview and factory audit checklist to prepare a more complete capacity discussion.

Limitations and Update Note

This article is a sourcing and production-planning guide, not a guaranteed delivery calendar. Public holidays, freight conditions, factory capacity and raw-material lead times vary by province, product type, supplier, port, destination and order stage. Buyers should confirm holiday arrangements with the specific factory, shipping schedules with their forwarder and compliance requirements for the exact target market.

Information was reviewed on August 3, 2026. Dates and freight guidance should be rechecked before approving orders, booking inspection or reserving cargo space.

Conclusion

For Q4 kitchen appliance orders, production-slot booking is a management discipline, not a calendar request. The buyer must connect product decisions, sample approval, BOM control, packaging, compliance evidence, inspection timing and logistics before asking the factory to commit line capacity.

The 2026 Mid-Autumn and National Day holiday pattern makes August especially important. Buyers who prepare complete RFQs, freeze critical components and confirm inspection and cargo-ready windows early will have more realistic choices. Buyers who wait until late September may still find a supplier willing to try, but the recovery margin becomes thin and expensive.

FAQ

When should importers book Q4 production slots with Chinese appliance factories?

For 2026 Q4 shipments, buyers should start serious slot discussions in early August and aim to lock key decisions during August whenever customization, compliance review, packaging or freight peak pressure is involved.

Does a purchase order automatically reserve factory capacity?

No. A purchase order supports the reservation, but a reliable slot also depends on sample approval, BOM status, material availability, payment release, packaging readiness and factory capacity.

Why does Golden Week affect production even before October 1?

Factories, component suppliers, forwarders and carriers prepare before the holiday. Exporters often rush cargo before the shutdown, which can tighten inspection, trucking, container and sailing availability before the official holiday starts.

What should be frozen before mass production?

Buyers should freeze the approved sample, critical BOM, substitute-component rules, market-specific documents, packaging artwork, manual language, plug type, carton details and inspection plan.

What if the factory cannot confirm a firm date?

Ask for release conditions and a conditional schedule. A conditional schedule is more useful than a vague promise because it shows what must happen before the date can become firm.

Planning a Q4 kitchen appliance order? Share your product category, target market, order quantity, sample status, customization scope, certificate requirements and preferred cargo-ready window with APEXDURA. Our team can help review whether the project is ready for realistic OEM/ODM production-slot planning.

Contact APEXDURA to discuss your Q4 production schedule
